Step-by-Step: Foam Injection in Foundation Repair

Step-by-Step: Foam Injection in Foundation Repair

Alison R. Sinclair | 24 Apr 2025

Foundation foam injection follows systematic seven-step process: comprehensive site assessment identifying problems, strategic injection hole drilling, equipment setup and material preparation, controlled foam injection with real-time monitoring, immediate verification, hole patching, and final documentation ensuring successful repair.

Professional foundation repair requires methodical execution. Each step builds on previous work ensuring success. Polyurethane foam concrete lifting demands proven protocols and trained technicians. Understanding the complete process guides facility managers making informed decisions.

Key Takeaways

  • Comprehensive site assessment: Visual inspection identifies settlement patterns and distress indicators, ground-penetrating radar locates voids beneath foundations, soil borings reveal subgrade conditions and bearing capacity, elevation surveys document current conditions establishing baselines for comparison
  • Strategic drilling pattern: Holes space 4-6 feet apart based on void locations and settlement severity, 5/8-inch diameter minimizes slab penetrations, drill depth extends through foundation into subgrade 2-4 inches, systematic layout ensures complete coverage without excessive drilling
  • Controlled injection sequence: Start at lowest elevation working toward higher areas systematically, inject small foam quantities (10-30 lbs) per pass incrementally, multiple passes build support gradually preventing over-lift, laser monitoring tracks elevation continuously enabling precision adjustments
  • Real-time monitoring protocols: Rotary laser levels track elevation changes to 1/16 inch accuracy, multiple monitoring points ensure even lift distribution, operators adjust based on slab response immediately, prevents over-lifting damage to foundations and adjacent structures
  • Immediate verification procedures: Post-injection elevation surveys confirm target heights achieved, ground-penetrating radar rescanning verifies complete void filling, visual inspection detects any problems requiring correction, documentation establishes warranty baseline and project records
  • Quality control standards: Pressure and temperature monitoring ensures proper foam properties, component mixing verification prevents defects, cure time confirmation before loading, comprehensive documentation supports long-term performance tracking and maintenance

Phase 1: Pre-Injection Assessment

Foundation repair success depends on thorough evaluation. Comprehensive assessment reveals conditions and requirements. This critical phase guides all subsequent decisions.

Initial Site Inspection

Visual examination identifies obvious foundation problems and distress patterns. Experienced technicians recognize signs requiring detailed investigation. This initial survey establishes project scope.

Interior floor cracks indicate settlement locations and severity. Diagonal cracks at corners suggest differential movement. Horizontal wall cracks show structural distress. The crack patterns reveal underlying problem areas.

Inspection Checklist:

  • Interior floor crack mapping
  • Wall crack documentation with photos
  • Door and window alignment checks
  • Floor slope measurements
  • Exterior foundation inspection
  • Drainage system evaluation

Exterior foundation examination reveals structural condition. Visible cracks confirm serious problems. Horizontal separations suggest lateral pressure issues. Vertical settlement cracks show foundation movement.

Door and window operation testing indicates frame distortion. Sticking doors signal settlement-induced movement. Gap measurements quantify distortion severity. These functional problems confirm structural issues.

Subsurface Investigation

Ground-penetrating radar scanning locates voids beneath foundations. The technology reveals hidden cavities invisible from surface. Void size, depth, and distribution get mapped accurately.

Soil borings extract samples revealing subgrade conditions. Laboratory testing determines bearing capacity and composition. Moisture content affects material selection. This data guides foam specification.

Investigation Methods:

  • Ground-penetrating radar scanning
  • Soil boring samples to 6-10 feet
  • Standard penetration testing
  • Moisture content analysis
  • Water table depth measurement
  • Bearing capacity calculations

Elevation surveys document current foundation conditions. Multiple benchmark points establish baseline measurements. Laser levels provide 1/16 inch accuracy. The data quantifies settlement severity objectively.

Testing results determine injection strategy and requirements. Weak soils need higher-density foam formulations. High water tables require hydrophobic products. Proper assessment prevents inappropriate material selection.

Phase 2: Project Planning and Preparation

Assessment data gets translated into detailed execution plans. Proper planning ensures efficient successful completion. Multiple factors require coordination and consideration.

Injection Pattern Design

Testing results guide injection hole placement. Void locations determine primary injection points. Settlement patterns affect hole spacing and density. The design ensures complete treatment coverage.

Standard spacing ranges 4-6 feet for typical applications. Severe settlement may require closer 3-4 foot spacing. Light void filling allows wider 6-8 foot intervals. Customization optimizes effectiveness and economy.

Design Considerations:

  • Void locations from GPR mapping
  • Settlement severity measurements
  • Soil conditions and bearing capacity
  • Access limitations and constraints
  • Adjacent structure proximity
  • Utility locations preventing conflicts

Hole patterns typically follow grid layouts for uniform coverage. Perimeter-focused patterns address edge settlements. Custom approaches adapt to specific site conditions. The systematic design prevents gaps in treatment.

Drilling depth calculations account for void locations and soil profiles. Standard foundation treatments extend 12-24 inches into subgrade. Deeper problems may require 36-48 inch penetrations. Testing establishes appropriate depths.

Material and Equipment Staging

Proper equipment positioning enables efficient operations. Material accessibility prevents delays during execution. Staging location affects project efficiency significantly.

Proportioning units require level stable platforms for operation. Electrical power connections support heating systems. Adequate space allows safe equipment access. The setup location affects all subsequent work.

Staging Requirements:

  • Proportioning unit placement
  • Power supply connections
  • Material storage and access
  • Hose routing to injection areas
  • Safety barrier establishment
  • Equipment protection considerations

Foam component storage maintains required temperatures. Heating systems bring materials to 110-130°F optimal range. Temperature verification prevents reaction problems. Proper preparation ensures consistent foam properties.

Hose routing from equipment to injection areas gets planned carefully. Maximum lengths vary by equipment capabilities. Direct paths minimize pressure losses. The layout affects injection efficiency.

Phase 3: Drilling and Hole Preparation

Precision drilling creates injection access without damaging foundations. Proper execution prevents problems enabling effective treatment. This phase requires skill and appropriate equipment.

Drilling Execution

Standard 5/8-inch diameter holes penetrate foundations at marked locations. Rotary hammer drills equipped with carbide bits cut cleanly. Drilling proceeds perpendicular to surfaces typically. The small holes minimize slab penetrations.

Depth control ensures proper penetration through foundation into subgrade. Depth gauges or marked drill bits prevent excessive drilling. Typical depths extend 2-4 inches below slab bottoms. This provides adequate foam placement.

Drilling Procedures:

  • Mark injection hole locations accurately
  • Select appropriate carbide drill bit
  • Drill perpendicular to foundation surface
  • Control depth to specifications
  • Vacuum cuttings continuously during drilling
  • Verify each hole before proceeding

Vacuum extraction removes concrete dust and cuttings immediately. Clean holes enable better foam flow and observation. The cleanliness also maintains site appearance. Professional contractors prioritize this step.

Reinforcement detection prevents cutting rebar when possible. Metal detectors or ground-penetrating radar locate steel. Alternative hole positions avoid reinforcement. This protects structural integrity.

Hole Inspection and Preparation

Each drilled hole gets inspected before injection begins. Proper depth verification ensures adequate treatment reach. Obstructions get cleared enabling foam flow.

Compressed air blows loose debris from holes. This ensures clean pathways for foam injection. Water or mud indicating groundwater gets noted. The observations affect injection strategy.

Pre-Injection Checks:

  • Verify depth meets specifications
  • Clear debris from all holes
  • Note any water presence
  • Check hole alignment and position
  • Document any anomalies discovered
  • Prepare injection equipment

Unusual conditions discovered during drilling get documented. Unexpected voids or very weak soils may require plan adjustments. Groundwater flow indicates moisture requiring hydrophobic foam. The information guides real-time decisions.

Process PhaseDurationKey ActivitiesEquipment UsedCritical Success FactorsCommon Challenges
Site Assessment2-4 hoursInspection, GPR, soil testingGPR scanner, survey equipmentThorough investigation, accurate mappingHidden conditions, access limitations
Project Planning1-2 hoursPattern design, stagingComputer, planning toolsProper hole spacing, adequate coverageUtility conflicts, space constraints
Drilling1-3 hoursHole creation, cleaningRotary hammer drill, vacuumAccurate positioning, proper depthReinforcement, hard concrete
Equipment Setup30-60 minStaging, heating, testingProportioner, hoses, gaugesTemperature control, system checksPower availability, weather
Foam Injection2-6 hoursSystematic injection, monitoringInjection gun, laser levelsPrecise control, real-time adjustmentUnexpected voids, weather
Verification1-2 hoursSurveys, GPR rescan, inspectionLaser level, GPR, documentationConfirming targets, void fillingInterpretation accuracy

Phase 4: Equipment Setup and Testing

Proper equipment preparation ensures consistent foam properties. System checks prevent problems during execution. This phase establishes operational readiness.

Proportioning Unit Preparation

Component heating brings materials to optimal 110-130°F temperatures. Circulation systems distribute heat evenly through tanks. Temperature monitoring confirms readiness for injection. Cold materials produce inconsistent foam.

Pressure calibration verifies accurate component delivery. Both A and B sides require precise pressure control. Imbalanced pressures cause foam defects. Gauge verification prevents mixing problems.

System Checks:

  • Component temperature verification
  • Pressure gauge calibration
  • Hose connection inspection
  • Material level confirmation
  • Heating system function
  • Safety equipment testing

Material inventory confirms adequate supply for project. Volume calculations from planning guide ordering. Contingency amounts account for unexpected conditions. Running short requires costly re-mobilization.

Hose connections get inspected for leaks or damage. Loose fittings cause pressure losses affecting injection. Damaged hoses require immediate replacement. The thorough inspection prevents mid-project failures.

Injection Gun Testing

Gun operation testing ensures proper function before starting. Purge cycles clear lines of contaminated material. Test shots verify mixing and flow rates. These checks prevent wasting expensive materials.

Pressure gauge readings at gun confirm adequate delivery pressure. Comparison to proportioner gauges reveals line losses. Significant differences indicate flow restrictions requiring correction. The verification ensures proper injection.

Gun Preparation:

  • Purge contaminated material
  • Test injection and mixing
  • Verify pressure at gun
  • Check air purge function
  • Inspect gun condition
  • Confirm operator readiness

Air purge systems get tested maintaining open injection ports. This critical feature enables returning to previous holes. Proper purge function prevents plugged ports. The capability proves essential for precision work.

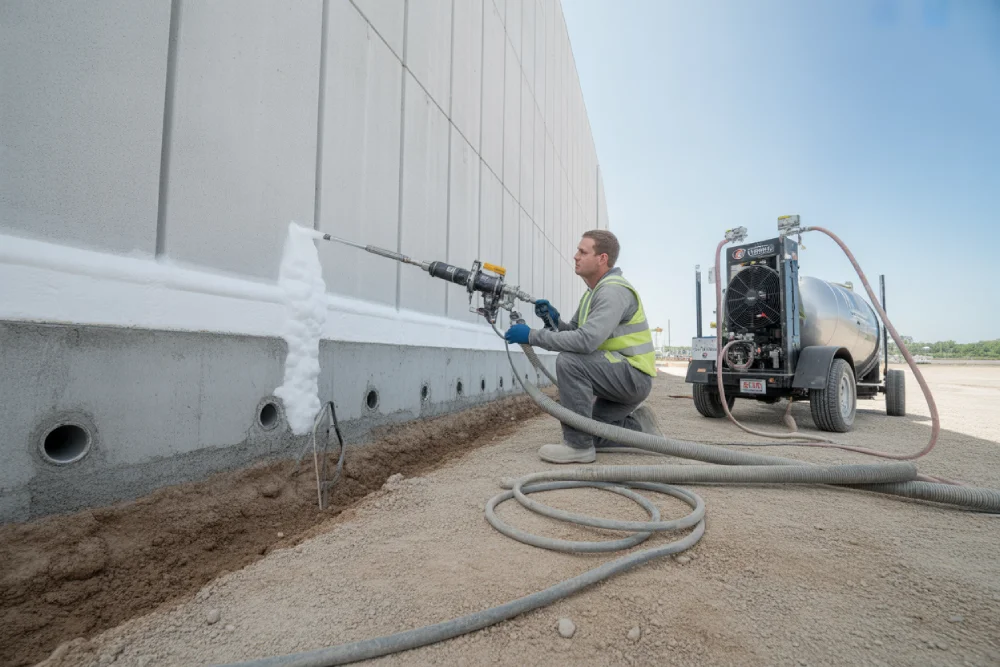

Phase 5: Systematic Foam Injection

Controlled injection proceeds following established protocols. Systematic execution ensures complete treatment and precision. This critical phase determines project success.

Injection Sequencing

Treatment begins at lowest elevation points where settlement is greatest. Foam injection works progressively toward higher areas. This sequence prevents material migration to already-treated zones.

Initial passes inject conservative foam quantities establishing baseline. Typical first-pass volumes range 10-20 pounds per hole. This conservative approach prevents over-lifting. Subsequent passes add material as needed.

Injection Protocol:

  • Start at lowest settlement areas
  • Inject small quantities initially (10-20 lbs)
  • Monitor elevation response continuously
  • Multiple passes add material incrementally
  • Work systematically across entire area
  • Document quantities and observations

Multiple monitoring points track elevation changes across foundations. Laser receivers at various locations show real-time movement. All points should rise relatively evenly. Differential readings indicate localized conditions.

Operators adjust injection quantities based on observed response. Rapid rise indicates reaching target or unexpected voids. Slow response suggests dense soil or large cavities. Experience guides interpretation and decisions.

Precision Control Techniques

Injection gun pressure monitoring guides material placement. Pressure spikes indicate blockage or breakthrough requiring response. Steady pressure shows normal flow and expansion. The observation prevents problems.

Component temperature maintenance ensures consistent foam properties. Temperature drops during injection affect reaction rates. Monitoring confirms heat systems maintain optimal ranges. Proper temperature proves critical for quality.

Control Parameters:

  • Gun pressure monitoring
  • Component temperature tracking
  • Flow rate observation
  • Elevation change rates
  • Visual slab response
  • Systematic hole progression

Air purge between holes maintains open ports for return visits. This enables precise incremental treatment impossible otherwise. The capability distinguishes professional from amateur execution. Proper use optimizes results.

Laser level observation frequency increases during active injection. Operators watch displays continuously while injecting. Immediate response to elevation changes prevents over-lift. The vigilance ensures precision within specifications.

Phase 6: Real-Time Monitoring and Adjustment

Continuous monitoring during injection enables precision impossible with older methods. Modern technology combined with operator skill achieves exceptional accuracy. Understanding monitoring importance explains superior results.

Laser Level Monitoring

Rotary laser systems establish horizontal reference planes. Receivers on foundation surfaces detect elevation relative to plane. Digital displays show measurements to 1/16 inch accuracy. This precision enables exceptional control.

Multiple receiver locations provide comprehensive coverage. Large foundations require 4-6 monitoring points minimum. All areas must rise uniformly preventing differential movement. The distributed monitoring ensures even results.

Monitoring Setup:

  • Position rotary laser centrally
  • Place receivers at critical points
  • Calibrate zero baseline readings
  • Set target elevation parameters
  • Monitor continuously during injection
  • Document all measurements

Target elevations get programmed based on pre-injection surveys. Receivers show difference from targets guiding injection. Approaching targets triggers reduced injection rates. Exact matching proves achievable consistently.

Monitoring frequency increases during active injection near targets. Operators watch displays every few seconds. Sudden changes trigger immediate response. The attention prevents over-lift accidents.

Adaptive Strategy Implementation

Unexpected slab responses require immediate strategy adjustments. Rapid rise indicates conditions differing from predictions. Operators modify injection approach based on observations. Flexibility proves essential for success.

Foam breakthrough through cracks shows paths to surface. Injection stops at that location immediately. Alternative holes continue treatment avoiding breakthrough areas. The adaptation prevents wasted material.

Adjustment Triggers:

  • Unexpected rapid elevation changes
  • Foam breakthrough to surface
  • Uneven lifting between points
  • Pressure anomalies during injection
  • Adjacent area movements
  • Any unusual observations

Inadequate rise despite foam injection suggests unexpected dense soil. Additional material or pressure increases may help. Alternative hole locations might prove necessary. Problem-solving skills guide decisions.

Adjacent unintended movement sometimes occurs from foam spreading. Monitoring reveals these secondary effects immediately. Injection strategy adjusts preventing unwanted changes. The comprehensive tracking maintains control.

Phase 7: Verification and Documentation

Post-injection verification confirms successful execution and results. Comprehensive documentation supports warranty and future reference. This final phase completes professional service.

Elevation Verification

Final elevation surveys measure achieved heights at all monitoring points. Comparison to baseline reveals actual lift accomplished. Target achievement confirms successful execution. Any deviations get documented explaining causes.

Tolerance specifications vary by application and agreement. Industrial facilities may require ±1/8 inch precision. Commercial applications accept ±1/4 to 1/2 inch typically. Meeting specifications proves essential for acceptance.

Verification Procedures:

  • Complete elevation survey all points
  • Compare to baseline measurements
  • Calculate deviations from targets
  • Document any out-of-tolerance areas
  • Photograph final conditions
  • Obtain owner acceptance signature

Out-of-tolerance areas require evaluation and potential correction. Sometimes conditions prevent exact matching. Engineering judgment determines acceptable variations. Documentation protects all parties.

Photography documents final conditions comprehensively. Before and after comparisons show correction achieved. The visual record supplements numerical data. Professional presentation enhances credibility.

Void Filling Confirmation

Ground-penetrating radar rescanning confirms complete void treatment. Comparison to pre-injection scans shows foam distribution. Complete filling validates thorough execution. Remaining voids indicate areas needing supplemental treatment.

Volume calculations verify adequate foam quantities were injected. Comparison to void estimates from planning confirms coverage. Significant discrepancies require investigation. The analysis ensures quality.

Quality Verification:

  • GPR rescan comparing to baseline
  • Volume calculation confirmation
  • Visual inspection all injection areas
  • Pressure and temperature log review
  • Material usage documentation
  • Final project report preparation

Final inspection examines entire project area. Patched holes should appear neat and professional. No foam residue should remain on surfaces. The finished appearance reflects contractor quality.

Comprehensive project documentation compiles all data. Elevation surveys, material quantities, and observations get organized. This record supports warranty and future maintenance. Professional contractors provide complete documentation.

Hole Patching and Site Restoration

Completing surface repairs maintains foundation appearance and function. Professional finishing reflects contractor quality. Proper patching prevents moisture infiltration.

Patching Material Selection

High-strength polymer cement matches existing concrete color closely. Fast-setting formulas enable rapid traffic resumption. Proper material selection ensures lasting repairs. Color matching maintains aesthetic appearance.

Epoxy-based patches provide maximum strength and durability. These premium products suit high-traffic areas. The superior performance justifies additional cost. Industrial applications often specify epoxy repairs.

Patching Options:

  • Polymer-modified cement (standard)
  • Fast-set mortar (rapid cure)
  • Epoxy compounds (maximum strength)
  • Color-matched materials (appearance)
  • Weather-resistant formulas (exterior)
  • Load-rated products (heavy traffic)

Exterior applications require weather-resistant formulations. Freeze-thaw durability proves essential in cold climates. UV resistance prevents degradation in sunlight. Proper selection ensures long-term integrity.

Application Technique

Hole cleaning removes dust and loose debris before patching. Compressed air or vacuum ensures proper preparation. Clean surfaces enable good patch adhesion. This step affects long-term performance.

Bonding agent application improves patch adhesion significantly. The primer creates mechanical and chemical bonds. Following manufacturer instructions ensures effectiveness. Proper bonding prevents patch failure.

Patching Steps:

  • Clean holes thoroughly
  • Apply bonding agent per specifications
  • Fill holes slightly overfull
  • Trowel smooth and level
  • Protect during curing period
  • Inspect after cure completion

Patching material fills holes slightly overfull initially. Material settling during cure requires this excess. Troweling smooth creates flush surface. The technique ensures professional appearance.

Curing protection prevents premature loading or damage. Traffic restrictions last 1-2 hours typically. Weather protection prevents washing or freezing. Proper curing ensures lasting repairs.

Conclusion

Foundation foam injection follows systematic seven-step process ensuring successful stabilization. Comprehensive site assessment including GPR scanning and soil testing identifies conditions guiding all decisions. Strategic drilling creates precise injection access without excessive foundation penetration. Equipment preparation and system testing verify proper operation before starting. Controlled systematic injection with real-time laser monitoring achieves precision within 1/8 inch tolerances. Immediate verification through elevation surveys and GPR rescanning confirms complete treatment. Professional hole patching and documentation complete the service. Each step builds on previous work creating integrated process. Skipping steps or inadequate execution risks project failure. Professional floor leveling company services deliver reliable results through proven protocols. Need expert foundation repair? Contact us to discuss systematic foam injection solutions for your facility.

FAQs
Small foundation repairs (500-1,000 SF) complete in 4-6 hours typically including all phases. Medium commercial projects (1,000-5,000 SF) require 6-12 hours for thorough execution. Large industrial foundations exceeding 5,000 SF may need multiple days completing systematically. Time varies significantly based on settlement severity and site conditions encountered.
Yes, foam injection works in occupied facilities with coordination around operations. Small injection holes and quick cure enable treatment without tenant relocation. Interior or exterior access provides flexibility. The non-invasive process proves ideal for operating buildings requiring minimal disruption versus traditional methods.
Rotary laser levels creating 360-degree reference planes with receivers tracking elevation to 1/16 inch accuracy. Multiple monitoring points across foundations ensure even lift distribution. Pressure gauges at proportioner and injection gun confirm proper foam delivery. Component temperature sensors verify optimal reaction conditions. The integrated monitoring enables exceptional precision.
Light operations resume 30-60 minutes after injection as foam achieves working cure. Full structural loads become safe within one hour of completion. Heavy equipment and maximum design loads wait until complete cure finishes. Most facilities return to normal operations same day after treatment.
Inadequate site assessment missing critical subsurface conditions causes most failures. Improper foam selection for soil and moisture conditions reduces effectiveness. Over-injection from poor monitoring damages foundations. Skipping verification steps prevents detecting incomplete treatment. Using inexperienced contractors increases all failure risks dramatically. Proper execution following proven protocols prevents most problems.
Extreme cold below 20°F may require special procedures or delays. Component heating maintains optimal temperatures despite weather. Rain doesn't prevent work but affects site conditions. High winds can interfere with laser monitoring outdoors. Indoor projects proceed year-round regardless of weather. Outdoor work continues most conditions with proper preparation.
Hole quantity depends on foundation size and void distribution. Typical spacing of 4-6 feet requires approximately one hole per 16-36 square feet. A 2,000 SF foundation needs 55-125 holes typically. GPR mapping reveals void locations requiring targeted drilling. Conservative drilling prevents inadequate coverage requiring additional holes.
Post-injection elevation surveys comparing to baselines confirm target achievements. Ground-penetrating radar rescanning validates complete void filling. Visual inspection detects any surface problems. Material quantity reconciliation ensures adequate foam injection. Comprehensive documentation provides objective success confirmation. Professional contractors routinely verify all critical parameters.
Yes, additional foam injection addresses inadequate initial treatment effectively. The process repeats systematically adding material where needed. Air purge injection guns enable returning to previous holes easily. Supplemental work proves common for large or complex projects. Proper monitoring identifies needs before project completion.
Slab-on-grade foundations receive standard injection through top surface. Basement floors get treatment from interior or exterior access. Pier and beam foundations require soil stabilization beneath grade beams. Each type presents unique access and execution challenges. Professional contractors adapt proven protocols to specific conditions ensuring successful outcomes.
Find Out How We Can Engineer a Solution For You
Superior Polylift Logo
A Division of Superior Grouting
crossmenu linkedin facebook pinterest youtube rss twitter instagram facebook-blank rss-blank linkedin-blank pinterest youtube twitter instagram Skip to content
